Pro Guides

How to Start a Pool Cleaning Business

What it costs to start, which licenses eight states ask for, the insurance a one-truck owner carries, and how to price and find your first pools.

Written Sources at the bottom

Illustration of a pool cleaning route: a service truck on a street grid stopping at backyard pools, with the headline Start a pool cleaning business and the figure about $2,130 to start, before a vehicle
About $2,130 to start, before a vehicle: tools, starter chemicals, a CPO course, registration if you need it, a month of insurance and postcards, at prices checked September 29, 2026 (our estimate).

The short answer

To start a pool cleaning business, budget about $2,130 before a vehicle (our estimate from September 29, 2026 prices): about $420 of tools, about $415 of starter chemicals, a first month of general liability and commercial auto insurance (Insureon, an insurance marketplace, reports $95 and $250 a month, September 3, 2026; the auto figure covers pool and other cleaning businesses; not a quote), $260 of postcards and, if needed, a $390 CPO course and up to $300 to register. Equipment repair is licensed in AZ, CA, FL and NV; ask your board about routine cleaning. General information, not legal, tax or insurance advice.

Starting from zero? PoolChecker Pro keeps your customers, routes and service visits in one app, on the web, iPhone and Android. Free up to 14 pools.

See PoolChecker Pro
At a glance: starting a pool cleaning business (prices checked September 29, 2026)
Cash to start, before a vehicleAbout $2,130, our estimate: tools, starter chemicals, a CPO course, registration if you need it, the first month of insurance and 1,000 postcards. A route broker, National Pool Route Sales (brokers sell routes), estimates $5,000 to $20,000 with a vehicle.
Insurance$95 a month for general liability (Insureon, pool cleaning companies, September 3, 2026) and $250 a month for commercial auto (pool and other cleaning businesses). Not a quote.
License lineEquipment repair is licensed in AZ, CA, FL and NV; whether routine cleaning is covered varies by state, so ask your board. Texas has no state pool license.
CPO certification$390 at The Training Center in 2026; valid 5 years. A CPO or an equivalent course is required for some public pools, and Miami-Dade County's pool cleaner registration requires the CPO.
Buying a route instead10 to 12 times its monthly billing (National Pool Route Sales FAQ, April 6, 2026), plus the same tools, chemicals and insurance.
What companies chargeWeekly service averaged $150 a month in Florida and $175 in Southern California in 2026 (Service Industry News survey).
SeasonPools stay open all winter in Phoenix, Houston, Orlando and Los Angeles; Minneapolis's warm stretch (normal daily mean 65°F or above) runs about June 1 to September 13 (NOAA 1991-2020 normals).

The roadmap

What are the steps to start a pool cleaning business?

Starting a pool cleaning business takes eight steps, in this order: check your license rules, register if you need to, get insured, buy tools and chemicals, get certified if your accounts need it, set your prices, find your first customers and plan for your season.

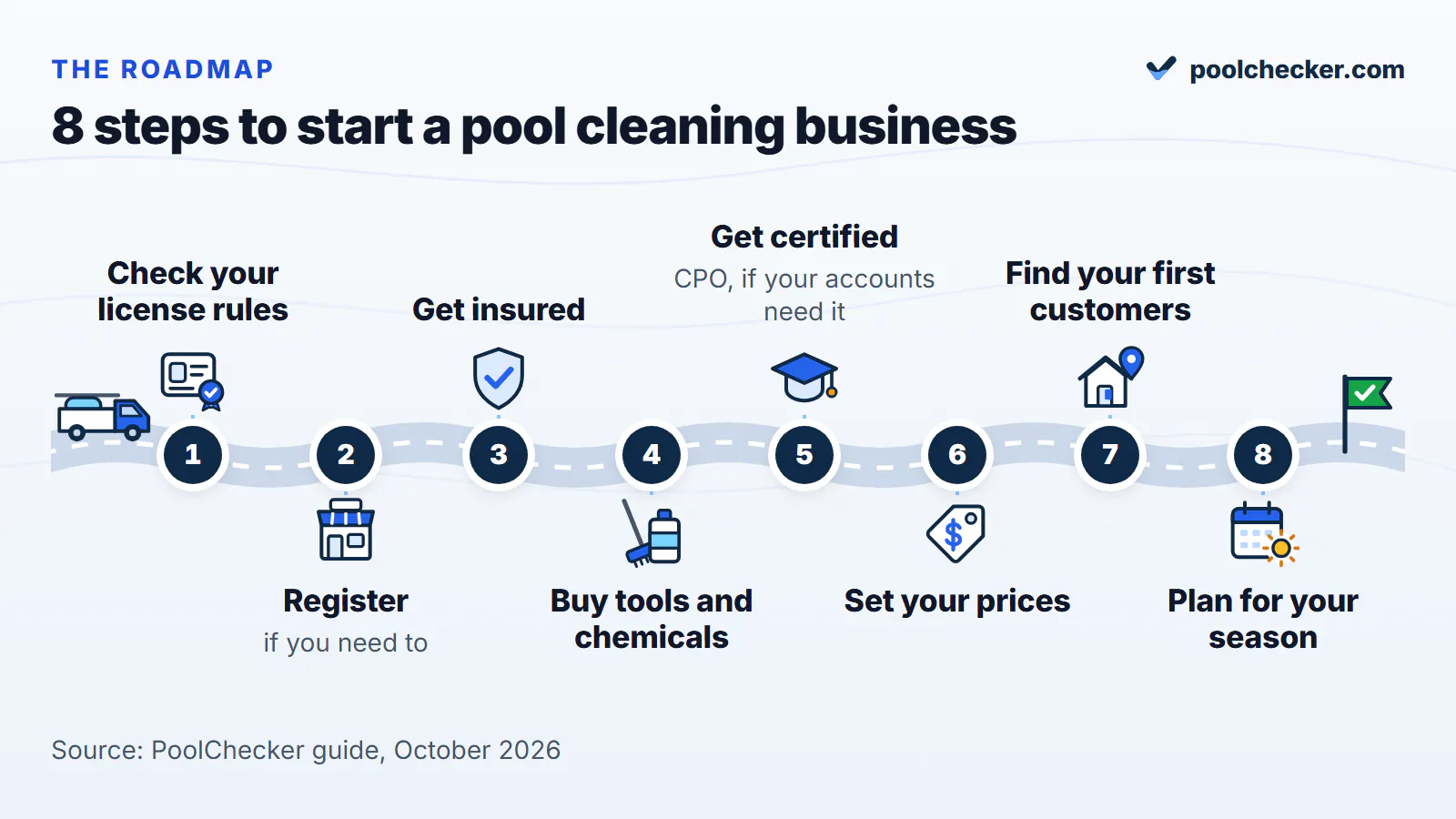

Roadmap of the 8 steps to start a pool cleaning business: 1 check your license rules, 2 register if you need to, 3 get insured, 4 buy tools and chemicals, 5 get certified (CPO if your accounts need it), 6 set your prices, 7 find your first customers, 8 plan for your season
The eight steps, in order. Each one has its own section below.
  1. Check your license rules
  2. Register (if you need to)
  3. Get insured
  4. Buy tools and chemicals
  5. Get certified (CPO if your accounts need it)
  6. Set your prices
  7. Find your first customers
  8. Plan for your season

Startup costs

How much does it cost to start a pool cleaning business?

Starting a pool cleaning business costs about $2,130 before a vehicle, by our estimate from prices checked September 29, 2026: tools, starter chemicals, a CPO course, business registration if you register a name, the first month of insurance and 1,000 postcards. A route broker, National Pool Route Sales, estimates $5,000 to $20,000 to start a solo company with a vehicle (FAQ, April 6, 2026); brokers sell routes.

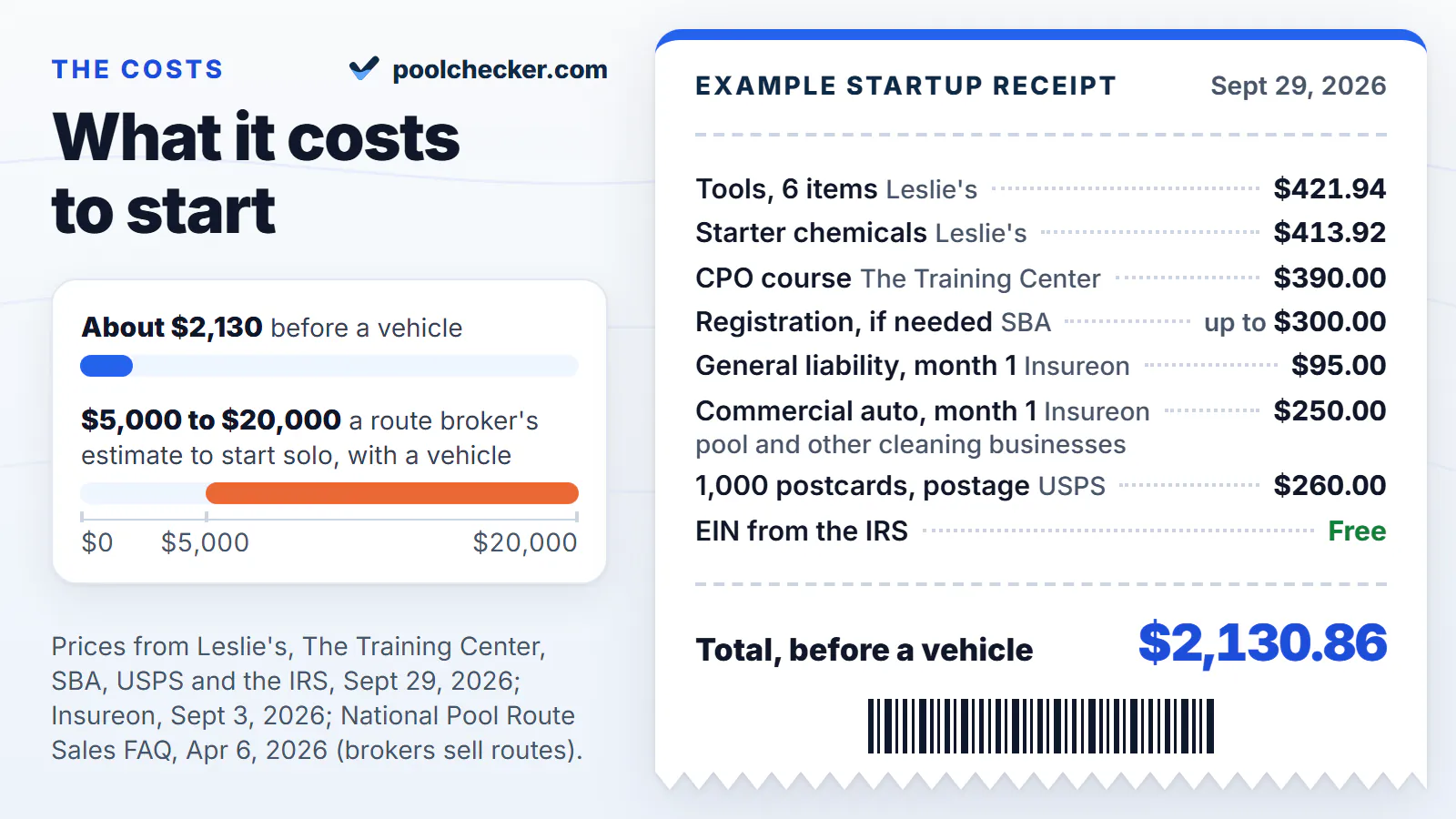

Receipt-style startup costs for a pool cleaning business: tools $421.94, starter chemicals $413.92, CPO course $390, business registration up to $300 if you register a name, general liability first month $95, commercial auto first month $250 (pool and other cleaning businesses), 1,000 postcards $260; total $2,130.86 before a vehicle. A route broker estimates $5,000 to $20,000 with a vehicle. Prices checked September 29, 2026
About $2,130 before a vehicle. Tools about $420, starter chemicals about $415, CPO $390, registration up to $300 if you register a name, first-month general liability $95 and commercial auto $250 (pool and other cleaning businesses), postcards $260. Prices from Leslie's, The Training Center, the SBA, Insureon and USPS, checked September 29, 2026.

The vehicle is the big variable: Cox Automotive put the average used-vehicle listing, all vehicle types, at $27,239 in August 2026. Insureon reports monthly and yearly figures; ask your agent what is due when the policy starts. A full first year runs $1,143 for general liability plus $3,001 for commercial auto (Insureon's figure for pool and other cleaning businesses). The prices are one retailer's on one date; distributors don't publish trade prices. Ask a local pool supply distributor about a trade account, and ask your state whether you can buy chemicals for resale tax-free (Connecticut treats a pool service company as the consumer of its supplies, and Florida's cleaning rule has cleaning providers pay tax on theirs).

Work out your number: the startup cash checklistUntick what you already have. Prices checked September 29, 2026.
Startup cash for a pool cleaning business
Count itItemCost
8 to 16 ft pro telescopic pole $69.99, 18 in pro leaf rake $39.99, pro utility brush $39.99, 19 in pro vacuum head $59.99, 45 ft x 1.5 in vacuum hose $96.99, Taylor K-2006 test kit $114.99. Leslie's.$421.94
A 50 lb bucket of 3 in tabs $224.99, five 4-packs of 1 gal liquid chlorine at $29.99, two 2-packs of 1 gal muriatic acid at $19.49. Leslie's regular prices; the quantities are an example, not a recommendation.$413.92
The Training Center, 2026 tuition, which it says PHTA sets. Not required everywhere.$390.00
Only if you register a business name or form an LLC or corporation. The SBA says it usually costs less than $300, and nothing under your own legal name.$300.00
EINFree from the IRS. Needed if you hire or form a partnership or corporation.$0.00
Insureon, an insurance marketplace, reports $95 a month for pool cleaning companies (September 3, 2026). Not a quote. Ask what is due at signing.$95.00
Insureon, for pool and other cleaning businesses. Untick it if your insurer covers business use of your own vehicle. The Insurance Information Institute says a personal policy covers only some business use. Ask what is due at signing.$250.00
USPS Every Door Direct Mail Retail at $0.26 each, postage only; printing extra.$260.00
Average used-vehicle listing price, August 2026, all vehicle types (Cox Automotive). Tick it to add it.$27,239.00
Your numberOur estimate from the prices above, before a vehicle.$2,130.86

Keeping that insurance the full first year adds $3,799 beyond the first month counted above, at Insureon's yearly figures (commercial auto is for pool and other cleaning businesses).

A route broker estimates $5,000 to $20,000 to start a solo operation from scratch, vehicle included (National Pool Route Sales FAQ, April 6, 2026; brokers sell routes).

Step 1: Licenses

Do you need a license to clean pools?

No state rule we found in these eight states (Arizona, California, Florida, Nevada, Texas, Georgia, North Carolina and Connecticut) names routine weekly cleaning as licensed contractor work, but the lines differ, and equipment repair is licensed in Arizona, California, Florida and Nevada.

Arizona's R-6 license covers the right to "service and perform minor repair" of residential pools, so ask the Registrar of Contractors. Florida licenses cleaning that needs partial disassembly (filter changes excluded). Connecticut's pool license names draining, acid washing and backwash filtration. Texas has no state pool license. Georgia and North Carolina license contracting by job value. Counties can add rules: Miami-Dade registers residential pool cleaners.

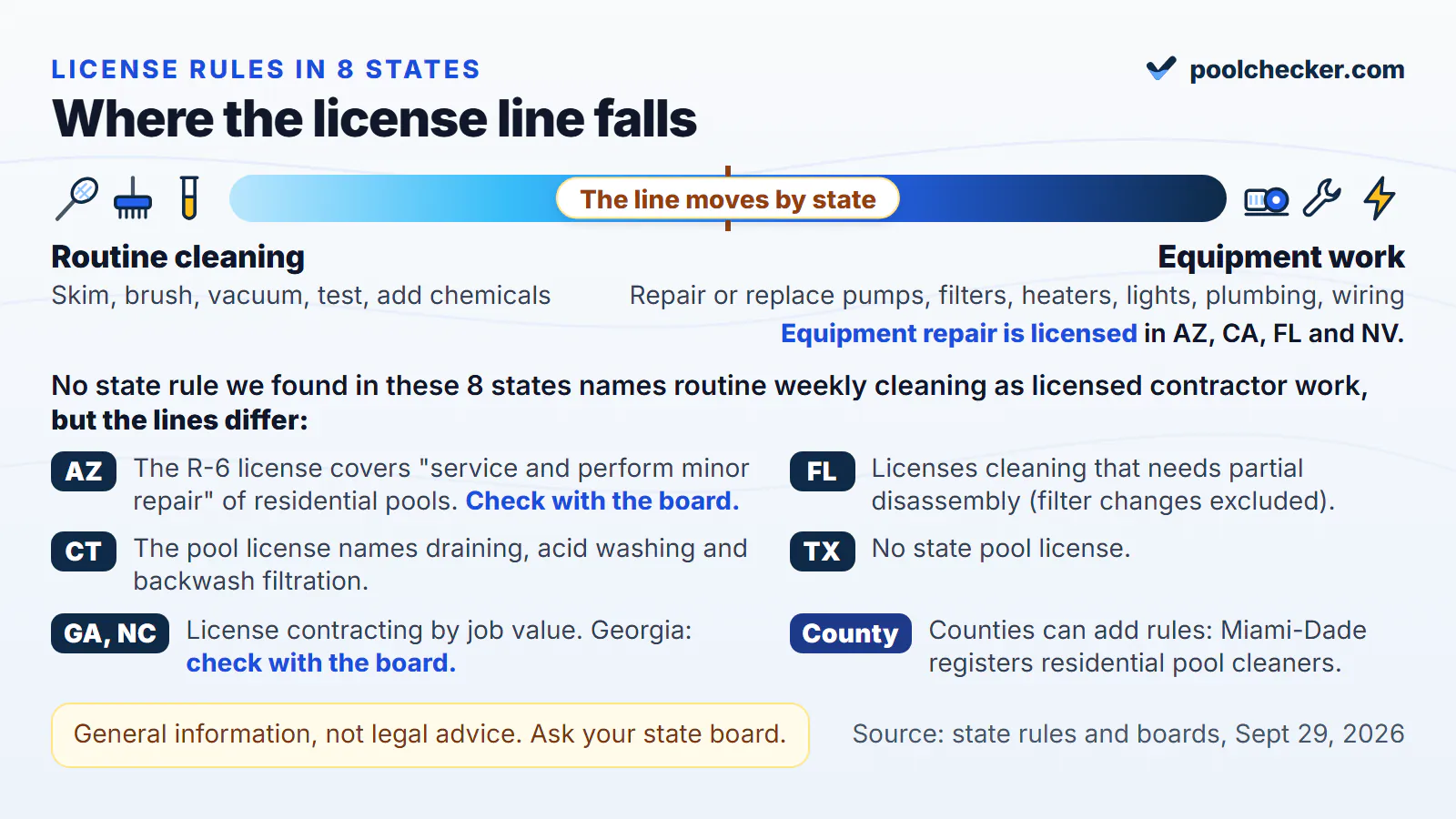

Where the license line falls for pool work: routine cleaning (skim, brush, vacuum, test, add chemicals) at one end and equipment work (repair or replace pumps, filters, heaters, lights, plumbing, wiring) at the other, with state exceptions for Arizona, Florida, Connecticut, Texas, Georgia, North Carolina and Miami-Dade County. General information, not legal advice; ask your state board
Where the line falls. Equipment repair is licensed in AZ, CA, FL and NV; whether routine cleaning is covered varies by state. General information, not legal advice.
The rules in eight states, and who to askWeekly cleaning, equipment work and public pools, checked September 29, 2026.
Pool work licensing in eight states. General information, not legal advice.
StateWeekly cleaningEquipment workPublic pools and local rulesAsk
ArizonaCheck with the board: the R-6 license covers the right to "service and perform minor repair" of residential pools (Ariz. Admin. Code R4-9-103).R-6 (residential), C-6 (commercial) or CR-6 (both). Handyman exemption: under $1,000 in total, no permit, and ads must say "not a licensed contractor" (A.R.S. 32-1121).Ask your county health department.Registrar of Contractors
CaliforniaNot in the D-35 license description. Chlorine work needs no pest control business license unless you use restricted materials (California Department of Pesticide Regulation).D-35 Pool and Spa Maintenance: motors, pumps, filters, gas heaters, lights and acid baths. Minor work up to $1,000 is exempt with no permit and no employees on the job (since January 1, 2025).Ask your county health department.Contractors State License Board
FloridaNo license for cleaning that "does not affect the structural integrity of the pool or spa or its associated equipment" (Fla. Stat. 489.105). Cleaning that needs partial disassembly is licensed (filter changes excluded): ask before you sell filter cleans.Repair or replacement of equipment, heaters and piping needs a swimming pool/spa servicing contractor license.A Public Pool Service Technician course of at least 16 hours, plus a test. Miami-Dade registers residential pool cleaners: $60 a year, a CPO certificate and liability insurance.DBPR and your county
NevadaNot named in the A-10e pool license scope (NAC 624.150).A-10e: repair of pumps, filters, heaters, timers, controls, lights, plaster and tile. Work under $1,000 is exempt, with conditions: no permit, not part of a larger job, and no plumbing or electrical type work (NRS 624.031).Companies serving Southern Nevada Health District permitted pools must register; their operators need a national certification.State Contractors Board
TexasNo state pool license: the Texas Department of Licensing and Regulation has no pool or spa program.Wiring is electrical work, which the same department licenses.Ask your city or county. Pool cleaning is a taxable service in Texas.TDLR and your city
GeorgiaCheck with the board.The residential contractor license applies to jobs over $2,500 (O.C.G.A. 43-41-2); the board decides which specialty trades are exempt.A trained operator with an approved course certificate, and at least two visits a week (Georgia Department of Public Health).State Licensing Board for Residential and General Contractors
North CarolinaLicensing is by job value: the general contractor license starts at $40,000 (N.C.G.S. 87-1), far above a weekly visit.Electrical and plumbing work have their own licensing boards.A trained operator; an operator certificate from the National Swimming Pool Foundation or a similar course is accepted (15A NCAC 18A .2537, as quoted by Brunswick County).Licensing Board for General Contractors
ConnecticutAsk first. The SP-1 license covers "the performance of all plumbing, heating and electrical work necessary to service, modify or repair" a pool, including "the draining, acid washing or backwash filtration of a swimming pool".An SP-1 contractor, or an SP-2 journeyperson working under one.Ask your local health department.Department of Consumer Protection

Every other state: ask your state contractor board and your county. The first pump, heater or plumbing job over your state's small-job limit, or one that needs a permit, takes you into licensed work.

Step 2: Register (if you need to)

Do you need an LLC, an EIN or a business code?

You don't need an LLC or an EIN to start a pool cleaning business: the U.S. Small Business Administration (SBA) says that if you do business under your own legal name, you won't need to register anywhere, and registering a business name or forming an LLC or corporation usually costs less than $300. Your city or county may still want a general business license, so ask them.

Business setup for a pool cleaning company
ItemWhat it meansAsk
Business name or LLCOptional under your own legal name; registering one usually costs under $300.SBA and your state
EINFree and issued online right away; you need one to hire employees or run a partnership or corporation. The IRS warns about websites that charge for one.IRS
Business codeNAICS 561790: the Census Bureau's 2022 index lists "Swimming pool cleaning and maintenance services" under it, and the IRS Schedule C instructions call it "Other services to buildings & dwellings".IRS
Self-employment tax15.3% once your net earnings reach $400; quarterly estimated payments if you expect to owe $1,000 or more.IRS
Sales taxTexas, North Carolina and Connecticut tax pool cleaning itself. Florida's cleaning rule doesn't name pools.Your state revenue department

Is pool service taxable?

In Texas, North Carolina and Connecticut, yes: Texas lists "pool cleaning and maintenance" as a taxable service (34 Tex. Admin. Code 3.356), North Carolina taxes cleaning and vacuuming an in-ground pool, and Connecticut's regulation also treats you as the consumer of your chemicals. Florida's cleaning rule doesn't name pools: ask the Florida Department of Revenue. Ask your state before your first invoice.

Step 3: Get insured

What insurance does a pool cleaning business need?

Price general liability and commercial auto first: Insureon, an insurance marketplace, reports $95 a month for general liability for pool cleaning companies and $250 a month for commercial auto for pool and other cleaning businesses (September 3, 2026). Those are medians of quotes, not a quote, and about $1,143 and $3,001 a year.

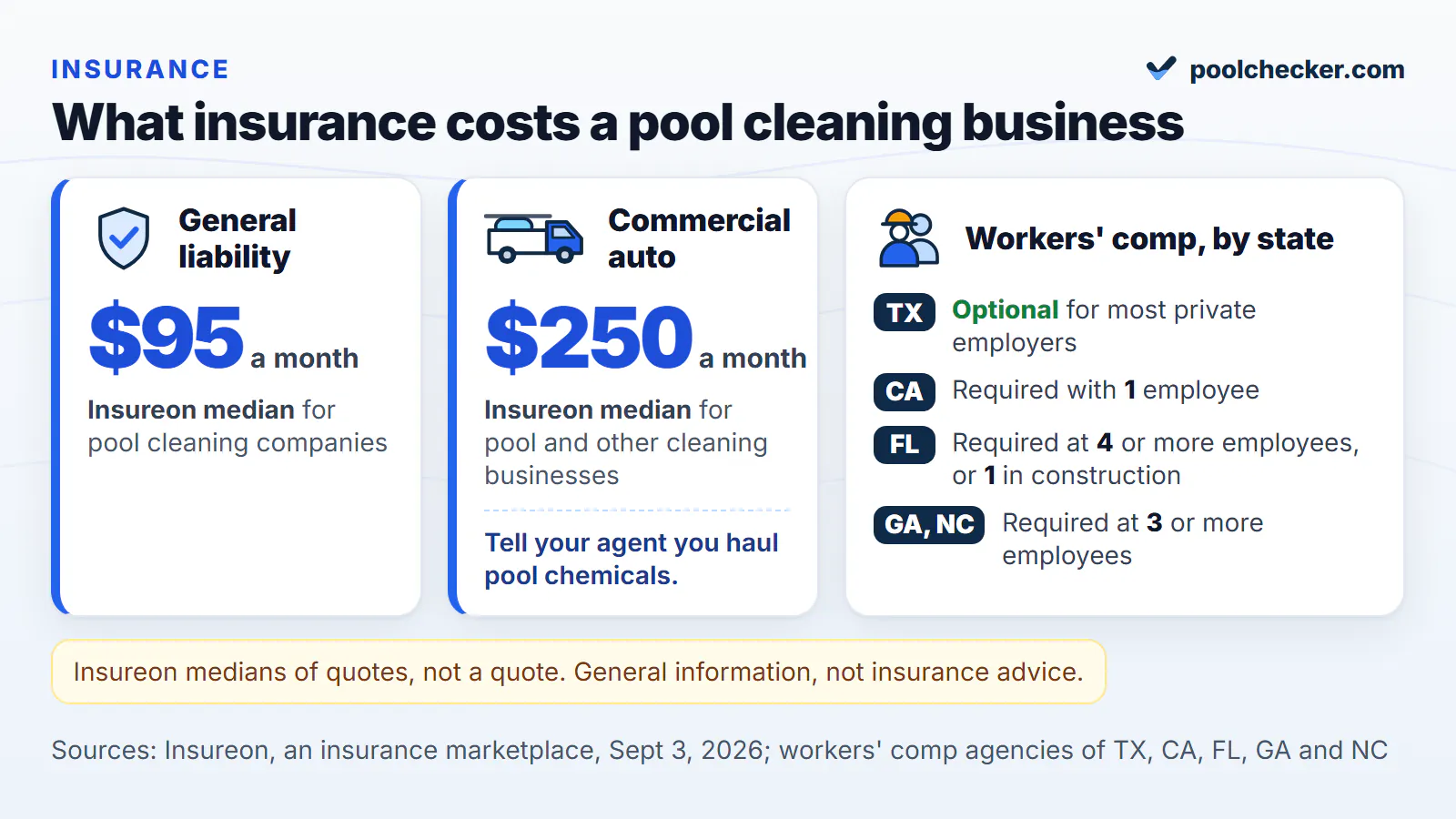

Insurance for a pool cleaning business: general liability $95 a month (Insureon, pool cleaning companies) and commercial auto $250 a month (pool and other cleaning businesses), plus when workers' comp is required: Texas optional, California with 1 employee, Florida at 4 outside construction, Georgia at 3, North Carolina at 3. Not a quote
$95 and $250 a month for general liability (pool cleaning companies) and commercial auto (pool and other cleaning businesses), Insureon, September 3, 2026; not a quote. Workers' comp: optional in Texas, required with one employee in California, at four in Florida outside construction (one in construction), at three in Georgia and North Carolina.
  • Your own truck. The Insurance Information Institute says a personal auto policy covers only some business use, and a business owner's policy covers no vehicles. Tell your agent you haul pool chemicals.
  • Local minimums. Miami-Dade County requires at least $50,000 per occurrence for bodily injury and $25,000 for property damage to register as a pool cleaner.
Workers' comp: who has to carry itSix states, with the agency to ask.
When a pool cleaning business needs workers' compensation
StateWho must carry itAsk
TexasOptional for most private employers; employers without it must report that.Texas Department of Insurance
CaliforniaEvery employer, even with one employee.Department of Industrial Relations
FloridaFour or more employees outside construction, one or more in construction; officers and LLC members count. Ask which side your work falls on.Department of Financial Services
GeorgiaThree or more regular employees; LLC members and officers count.State Board of Workers' Compensation
North CarolinaThree or more regular employees.Industrial Commission
ArizonaAny employer with regularly employed workers.A.R.S. 23-902

Step 4: Tools and chemicals

What equipment do you need to start?

A basic kit of six tools cost about $420 at Leslie's on September 29, 2026: a telescopic pole, a leaf rake, a brush, a vacuum head, a 45 ft vacuum hose and a Taylor K-2006 test kit. Add a starter load of chemicals (about $415 in our example) and a safe way to haul it.

The vacuum head priced here is sold for concrete pools; for vinyl and fiberglass pools, buy a head made for those surfaces.

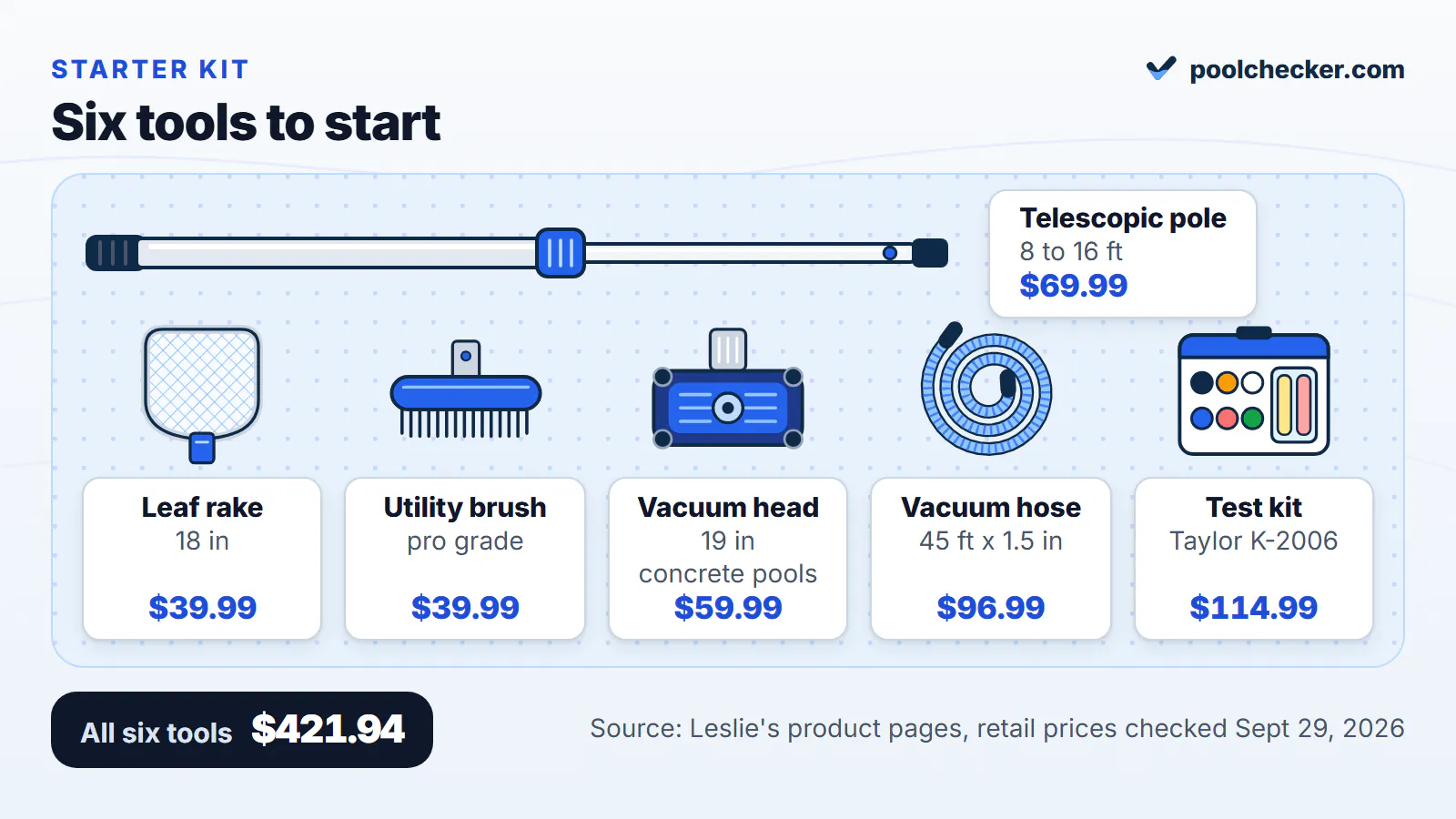

Drawing of six pool cleaning tools with prices: telescopic pole $69.99, leaf rake $39.99, utility brush $39.99, vacuum head for concrete pools $59.99, vacuum hose $96.99, Taylor K-2006 test kit $114.99; $421.94 in all at Leslie's, September 29, 2026
Six tools, about $420 at Leslie's prices on September 29, 2026; the vacuum head is for concrete pools. The itemized list is below.
Itemized: the tools and a starter chemical loadLeslie's product pages, September 29, 2026.
Tools and starter chemicals for a pool cleaning business
ItemPrice
8 to 16 ft pro telescopic pole$69.99
18 in pro leaf rake$39.99
Pro utility brush$39.99
19 in pro vacuum head (Leslie's sells it for concrete pools)$59.99
45 ft x 1.5 in vacuum hose$96.99
Taylor K-2006 test kit$114.99
Tools subtotal$421.94
50 lb bucket of 3 in chlorine tabs (regular price)$224.99
Five 4-packs of 1 gal liquid chlorine, $29.99 each$149.95
Two 2-packs of 1 gal muriatic acid, $19.49 each$38.98
Starter chemicals subtotal (an example, not a recommendation)$413.92

Leslie's says its muriatic acid is not recommended for fiberglass, vinyl liner or painted pools: one wrong product on the wrong surface is a damage claim.

Before your first stop, buy chemical splash goggles, liquid-impervious gloves and boots (the EPA's minimum for handling pool chemicals; for frequent handling it adds a face shield and an apron or coveralls), and never mix chlorine products with each other or with acid: NOAA warns that trichlor tablets and cal hypo react explosively in water.

Pool chlorine and acid are hazardous materials under federal rules. The materials of trade exception (49 CFR 173.6) caps each package of a Packing Group II or III material at 66 lb or 8 gallons and a vehicle's total at 440 lb. Once you hire, OSHA's Hazard Communication standard requires a written program, safety data sheets and training; the OSH Act doesn't cover the self-employed. Our pool service truck setup guide has the full kit list, the safety gear and the hauling rules.

Step 5: Certification

Do you need CPO certification?

CPO certification isn't required to clean a private backyard pool in the eight states we checked, but Miami-Dade County requires a CPO certificate to register as a pool cleaner, and public pools in Florida, Georgia, North Carolina and Southern Nevada need a trained or certified operator. The course cost $390 at The Training Center in 2026.

The Certified Pool & Spa Operator (CPO) certificate comes from the Pool & Hot Tub Alliance (PHTA). It is a 16-hour, two-day class, or an online course plus a one-day class, and it is valid for 5 years. Even where nobody requires it, it is a structured way to learn water chemistry.

Connecticut is different: its SP-1 license exam requires two years as a journeyman plus PHTA's CMS or CST certification (not the CPO) or equivalent courses. The public pool rules for each state are in the license table.

Step 6: Set your prices

How much should you charge?

Price from your own costs, then check the market: in Service Industry News's 2026 reader survey, pool companies reported charging an average of $150 a month in Florida, $175 in Southern California and about $225 in Texas for weekly residential service.

Average monthly price for weekly residential pool service by region, Service Industry News 2026 survey: Florida $150, Arizona about $150, Southern California $175, Texas about $225, Southeast outside Florida about $300; seasonal markets, in season: Northeast $433, Midwest about $255 (less reliable), where routes are run by companies with employees and multiple crews
Monthly price for weekly service, 2026: Florida $150, Arizona about $150, Southern California $175, Texas about $225, Southeast outside Florida about $300; in season in seasonal markets, Midwest about $255 and Northeast $433 (Service Industry News).
  • Seasonal markets. The Northeast's $433 and the Midwest's (about $255) are in-season prices, and Service Industry News says those routes are run by companies with employees and multiple crews rather than solo owners. It calls the Midwest figure less reliable.
  • Southern winters. Not every region on the chart works all year: many pools in the Southeast outside Florida and in North Texas close for winter (see the season dates).
  • Chemicals. The prices are not like for like. The share of respondents whose price includes chemicals was 92% in Southern California, nearly all in Florida, about 73% in the Southwest (which includes Arizona and Texas), 58% in the Southeast outside Florida, 54% in the Northeast and 33% in the Midwest.
  • Your costs. Count your time, chemicals, insurance, overhead and miles (the IRS business rate is 76 cents a mile from July 1, 2026) per pool, and never price below that. In Service Industry News's Southern California example, chemicals ran $1,900 a month for 75 pools, about $25 a pool. Pool & Spa News suggests aiming for two pools an hour.
  • Put it in writing. What the monthly price includes, what costs extra (filter cleans, green-pool cleanups, repairs), your billing date and how to cancel.

The survey is self-reported; Service Industry News calls it "not a purely scientific survey". Raising prices later? Use our pool service price increase letter.

Step 7: First customers

How do you get your first pool customers?

Start with a free Google Business Profile set up as a service-area business (Google allows up to 20 service areas), then mail postcards to the streets you want with USPS Every Door Direct Mail at $0.26 each.

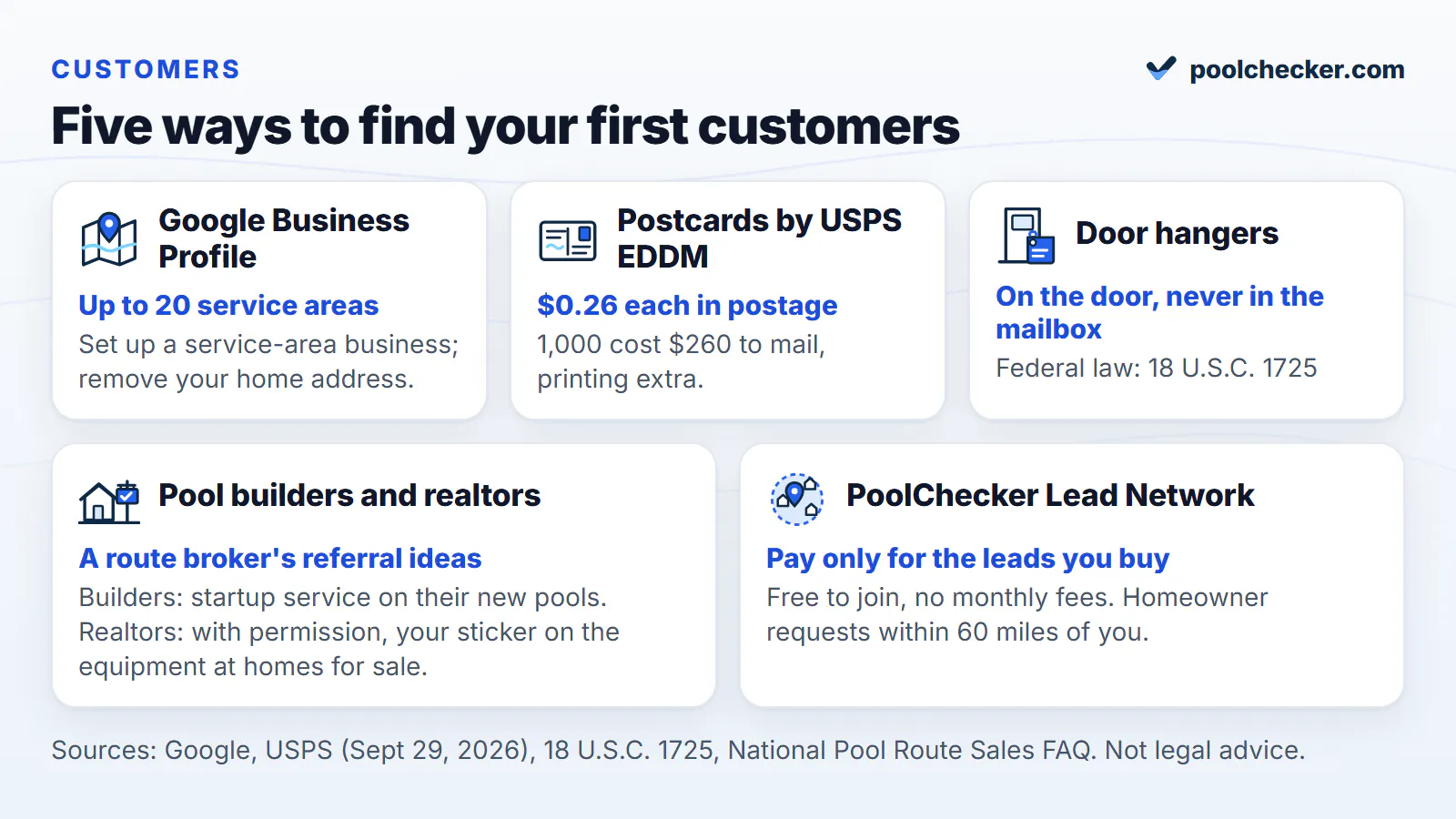

Five ways to find your first pool cleaning customers: a Google Business Profile as a service-area business with up to 20 service areas; USPS EDDM postcards at $0.26 each; door hangers on the door, never in the mailbox (18 U.S.C. 1725); pool builders and realtors, a route broker's suggestion; and PoolChecker's Lead Network, free to join, pay per lead you buy
Five channels: Google Business Profile, postcards at $0.26 each, door hangers (on the door, never the mailbox), builders and realtors, and the PoolChecker Lead Network.
  • Google Business Profile. If you serve customers at their homes, Google says to remove your address and list your service areas instead.
  • Postcards. 1,000 postcards cost $260 in postage through EDDM Retail, printing extra, with no mailing permit needed.
  • Door hangers. Hang them on the door, never in or on the mailbox: federal law (18 U.S.C. 1725) fines anyone who puts unpaid mailable matter in a letter box. General information, not legal advice.
  • Builders and realtors. Route broker National Pool Route Sales suggests offering builders free startup service on new pools (the first 30 days of chemistry) to become their preferred provider, and, with permission from realtors or property managers, putting your sticker on the equipment at for-sale homes.
  • Lead Network. PoolChecker's Lead Network is free to join with no monthly fees: you pay only when you buy a lead, and it matches you with homeowner requests within 60 miles.
  • Keep the route tight. Ask each new customer to mention you to their neighbors, and mail the same few neighborhoods: every pool on a street you already drive costs less to service.

Never serviced a pool? Consider working a season on an established company's route first, so you learn on someone else's accounts.

Step 8: Plan for your season

How long is pool season where you work?

Pools run all winter in Phoenix, Houston, Orlando and Los Angeles, but close for winter in Dallas, Atlanta, Charlotte and colder cities, and Minneapolis's warm stretch runs only about June 1 to September 13, by NOAA's 1991-2020 climate normals.

The dates are a swim-season proxy: the days when the normal daily mean air temperature is at or above 65°F. Where pools stay open all winter, service runs all year even outside that stretch. Of the 75 cities in our NOAA data, 7 keep pools open all winter, 8 have winters mild enough that closing is optional, and 60 close. In a closing market, time your start (and your chemical buying) to your opening season; you sell openings, summer service and closings, and need a plan for winter income. See when to open your pool and when to close your pool for all 75 cities.

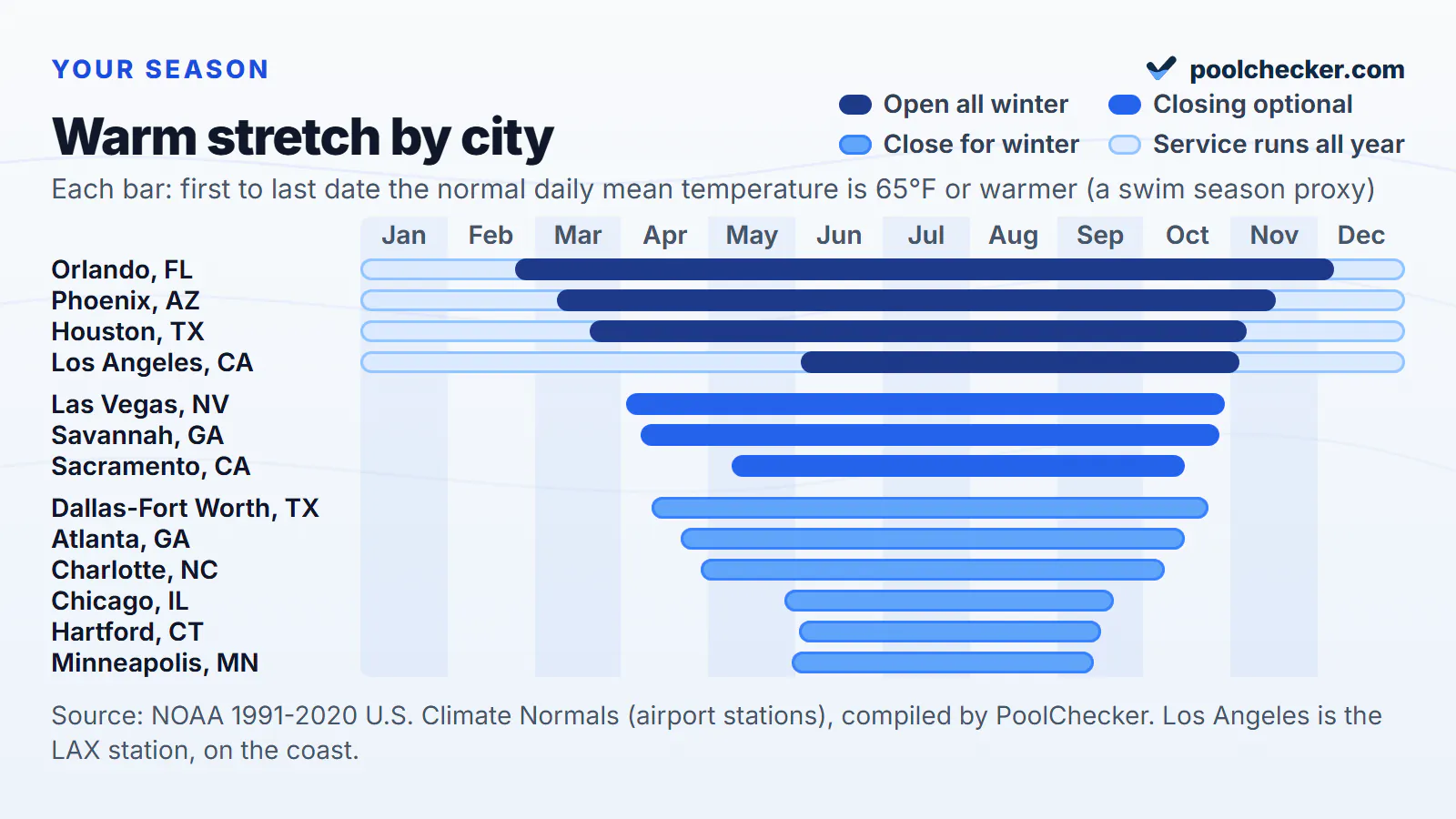

Gantt chart of the 65°F warm stretch in 13 US cities, from Orlando (February 24 to December 6) to Minneapolis (June 1 to September 13), with a full-year track where pools stay open all winter; every date is in the table below
Warm stretch by city (normal daily mean at or above 65°F), NOAA 1991-2020 normals. In the four open-all-winter cities, service runs all year. Every date is in the table below.
The dates for 13 citiesNOAA 1991-2020 normals, airport stations.
Warm stretch (normal daily mean at or above 65°F) and winter type by city
CityWarm stretchWinter
Orlando, FLFebruary 24 to December 6Open all winter
Phoenix, AZMarch 11 to November 16Open all winter (a freeze in about 1 winter in 6)
Houston, TXMarch 22 to November 6Open all winter
Los Angeles, CAJune 4 to November 3 (the LAX airport station, on the coast)Open all winter
Las Vegas, NVApril 4 to October 29Closing optional (mild winters)
Savannah, GAApril 9 to October 27Closing optional (mild winters)
Sacramento, CAMay 11 to October 15Closing optional (mild winters)
Dallas-Fort Worth, TXApril 13 to October 23Close for winter
Atlanta, GAApril 23 to October 15Close for winter
Charlotte, NCApril 30 to October 8Close for winter
Chicago, ILMay 29 to September 20Close for winter
Hartford, CTJune 3 to September 16Close for winter
Minneapolis, MNJune 1 to September 13Close for winter

Build or buy

Should you start from scratch or buy a pool route?

Starting from scratch takes about $2,130 in cash before a vehicle, while a route typically costs 10 to 12 times its monthly billing, says route broker National Pool Route Sales, and a buyer still needs the same tools, chemicals and insurance. A 26-pool Arizona route billing $3,350 a month was listed at $40,200 on September 29, 2026; the listings we checked that day asked 12 to 13 times their monthly billing.

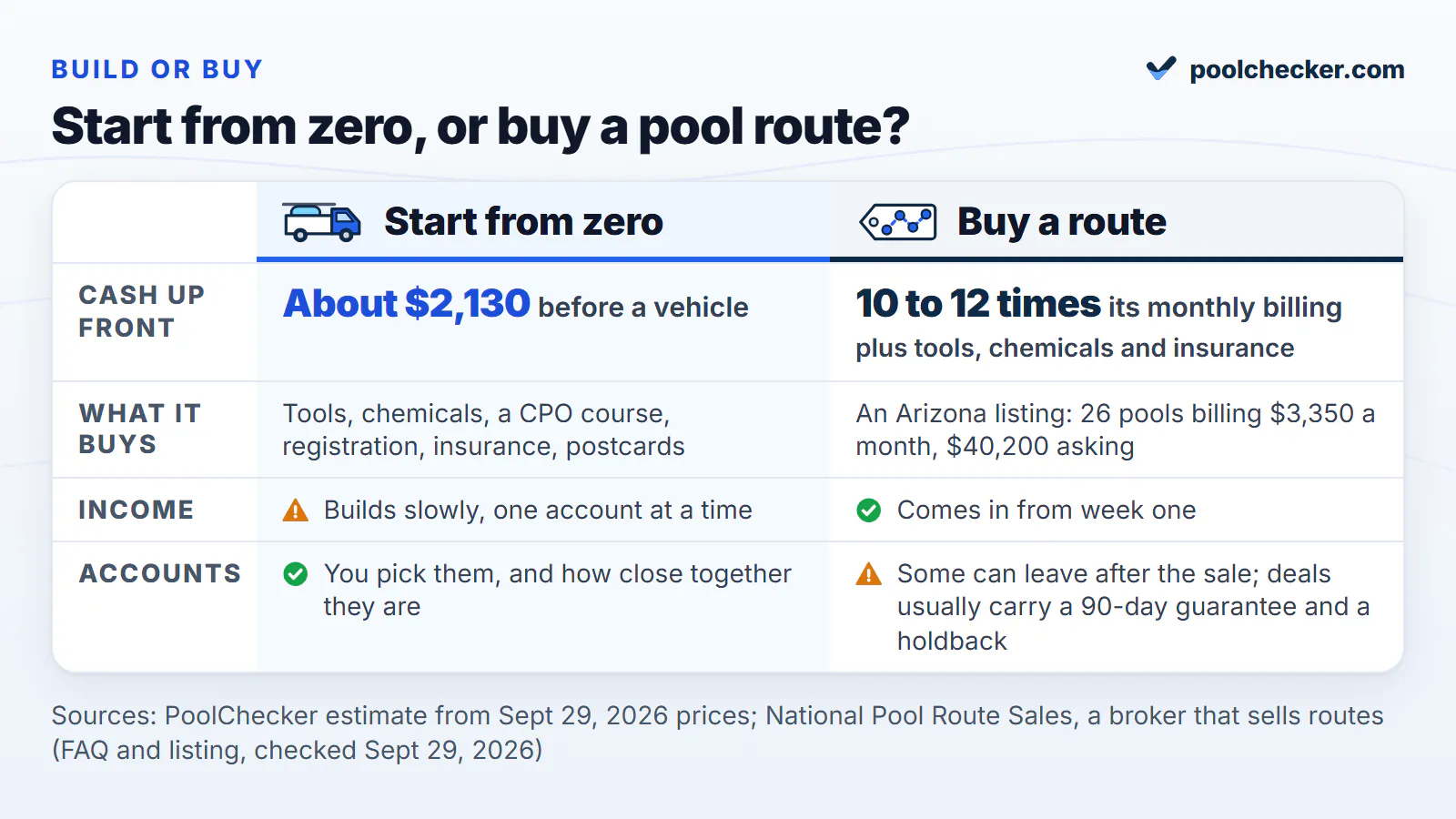

Start from zero versus buy a route. Starting from zero: about $2,130 cash before a vehicle, income builds slowly, you pick your accounts. Buying a route: 10 to 12 times monthly billing plus tools, chemicals and insurance, for example 26 pools at $3,350 a month listed at $40,200 in Arizona, income from week one, accounts can leave, and a 90-day guarantee and holdback are usual
Build: about $2,130 before a vehicle, slow income, your choice of accounts. Buy: 10 to 12 times monthly billing plus the same tools, chemicals and insurance (26 pools, $3,350 a month, $40,200 asking), income from week one.
  • Financing. National Pool Route Sales says bank loans for routes are rare because there is no physical collateral.
  • Accounts can leave. National Pool Route Sales put losses after a sale at one to two percent (2019); two owners in Pool & Spa News (2008) put them near 30 percent.
  • Protections. Broker deals usually come with a 90-day guarantee backed by a holdback of 10% or more of the price, about 30 days of training and a 5-year non-compete.

Brokers include National Pool Route Sales, SpringBoard Pool Route Brokers and Pool Route Sales USA; they are paid when routes sell. Our guide to buying a pool route covers prices, checks and deal terms.

The honest part

Is a pool cleaning business worth it?

A pool cleaning business can pay: Service Industry News's 2026 Southern California example, 75 weekly pools at $175 a month, leaves the owner $8,425 a month before taxes after $4,700 of monthly operating costs.

That is a large route. National Pool Route Sales calls about 50 pools the sweet spot for a solo operator (FAQ, April 6, 2026; treat it as rough), and a new company starts with none, so plan to cover your living costs while the route fills. The hard parts:

  • Heat. Phoenix averages 111.3 days a year at 100°F or hotter (NOAA normals). OSHA's advice: water, rest and shade.
  • Chemicals. Pool chemical injuries led to an estimated 4,535 U.S. emergency department visits a year from 2008 to 2017 (CDC), counting everyone, not only workers. Wear goggles, impervious gloves and boots, and never mix chlorine products or chlorine and acid.
  • You are the business. A sick week earns nothing unless someone covers your route; the Independent Pool and Spa Service Association (IPSSA) lists route coverage during illness among its member benefits.
  • Taxes. 15.3% self-employment tax, plus quarterly estimates (IRS). Set aside a share of every payment.
  • Survival. On average, 49.2% of new employer establishments survived five years (1994 to 2022, SBA Office of Advocacy citing BLS). That counts businesses with employees only.
More of the hard partsLicenses, surfaces, public pools and the rest of the heat data.
  • License creep. The first pump, heater or plumbing job over a state's small-job limit ($1,000 in Arizona, California and Nevada; $2,500 for Georgia's residential contractor license) or one that needs a permit takes you into licensed work.
  • Surfaces. Leslie's says its muriatic acid is not recommended for fiberglass, vinyl liner or painted pools.
  • Public pools. Since December 19, 2008, public pools and spas must have anti-entrapment drain covers that meet 16 C.F.R. part 1450 (CPSC).
  • More heat. Days a year at 100°F or hotter, and at 90°F or hotter: Phoenix 111.3 and 173.4, Las Vegas 78.2 and 137.1, Dallas-Fort Worth 20.3 and 106.2, Houston 7.0 and 111.3, Orlando 0.2 and 109.9 (NOAA 1991-2020 normals).
  • Seasons. In closing markets, cash slows down for the winter (see the season table above).

PoolChecker Pro

Run your route from your phone

PoolChecker Pro is software for pool service companies: your customers, routes, service visits and billing in one app, on the web and on iPhone and Android. It is free up to 14 pools, with no card.

  • Each day's stops come in drive order.
  • Each stop's photos, readings and checklist are saved, and chemical doses are sized to each pool's gallons.
  • Pause a pool for winter, and its schedule is still there in spring.
  • Bill only the months you service, once payments are set up. Payments carry Stripe's standard fee plus a platform fee of 0.9% to 2.5% depending on plan, taken from your payout.
  • Free up to 14 pools
  • Solo $24.99 a month, up to 50 pools
  • Pro $59.99 a month, unlimited pools, plus $24.99 a month for each tech or manager

Free and Solo are for a single operator. Every plan has every feature, month to month. Sign up on the web, then use the app on iPhone or Android.

PoolChecker Pro routes map with three techs' stops numbered in drive order around Phoenix (demo data)
A day's routes on the map, each tech's stops numbered in drive order (demo data).
PoolChecker Pro stop screen on a phone: Navigate and Notify, the pool's 17,000 gallons, and the visit checklist (demo data)
The stop screen: navigate, then the checklist, chemistry and photos.
PoolChecker Pro recurring billing set to charge March to October only (demo data)
Recurring billing for the months you pick, here March to October.

Questions

Starting a pool cleaning business: questions answered

How much does it cost to start a pool cleaning business?

About $2,130 before a vehicle, by our estimate from prices checked September 29, 2026: about $420 of tools, about $415 of starter chemicals, a $390 CPO course if your accounts need one, up to $300 only if you register a business name or form an LLC, a first month of insurance (Insureon, an insurance marketplace, reports $95 a month of general liability for pool cleaning companies and $250 a month of commercial auto for pool and other cleaning businesses; not a quote) and $260 to mail 1,000 postcards. National Pool Route Sales, a broker that sells routes, estimates $5,000 to $20,000 with a vehicle.

Do you need a license to clean pools in Florida?

Florida Statutes 489.105 says a license is not required for cleaning that does not affect the structural integrity of the pool or spa or its equipment. Equipment repair, and cleaning that needs partial disassembly (filter changes excluded), need a swimming pool/spa servicing contractor license, and Miami-Dade County registers pool cleaners. Ask the Florida DBPR and your county.

Do you need a license to clean pools in Texas?

Texas has no state pool license: the Texas Department of Licensing and Regulation has no pool or spa program, though wiring on pool equipment is electrical work, which it licenses. Texas does tax pool cleaning as a service. Ask your city about local permits and the Texas Comptroller about sales tax.

Do you need a license to clean pools in California?

Routine cleaning is not in the description of California's D-35 Pool and Spa Maintenance license, which covers installing, replacing or repairing pumps, motors, filters, gas heaters and lights. Since January 1, 2025, minor work up to $1,000 with no permit and no employees on the job is exempt. Ask the Contractors State License Board before equipment work.

Do you need a license to clean pools in Arizona?

Check with the Arizona Registrar of Contractors. Its R-6 license covers the right to "service and perform minor repair" of residential pools (Arizona Administrative Code R4-9-103), and a handyman exemption covers work under $1,000 with no building permit, if your ads say you are not a licensed contractor.

How much is insurance for a pool cleaning business?

Insureon, an insurance marketplace, reports $95 a month ($1,143 a year) of general liability for pool cleaning companies and $250 a month ($3,001 a year) of commercial auto for pool and other cleaning businesses (September 3, 2026). Those are medians of quotes, not a quote. Workers' comp depends on the state: optional for most private employers in Texas, required with one employee in California, at four employees outside construction in Florida, and at three in Georgia and North Carolina.

What equipment do you need to start a pool cleaning business?

A telescopic pole, a leaf rake, a brush, a vacuum head, a 45 ft vacuum hose and a Taylor K-2006 test kit: about $420 for the six at Leslie's on September 29, 2026. That vacuum head is sold for concrete pools; for vinyl and fiberglass pools, buy a head made for those surfaces. Add a starter load of chemicals (about $415 in our example), chemical splash goggles, liquid-impervious gloves and boots.

Do you need CPO certification to clean pools?

CPO certification isn't required to clean a private backyard pool in the eight states we checked, but Miami-Dade County requires a CPO certificate to register as a pool cleaner, and public pools in Florida, Georgia, North Carolina and Southern Nevada need a trained or certified operator. The course cost $390 at The Training Center in 2026, and the certificate is valid for 5 years.

Is a pool cleaning business profitable?

A pool cleaning business can be profitable once the route is full. Service Industry News's 2026 Southern California example, 75 weekly pools at $175 a month, leaves the owner $8,425 a month before taxes after $4,700 of operating costs. A new company starts with no pools, so plan to cover your living costs while the route fills. Results depend on your prices, route density and costs, and on average about half of new employer establishments survive five years (SBA Office of Advocacy).

What is the business code for a pool cleaning business?

NAICS 561790. The Census Bureau's 2022 NAICS index lists swimming pool cleaning and maintenance services under it, and the IRS Schedule C instructions describe 561790 as other services to buildings and dwellings.

Receipts

Sources

Every rule and industry number on this page comes from these sources. Totals and the season proxy are our own arithmetic from them.

All 48 sources, with dates
  1. 1Leslie's product pages, tools, prices checked September 29, 2026: 8 to 16 ft pro telescopic pole $69.99; 18 in pro leaf rake $39.99; pro utility brush $39.99; 19 in pro vacuum head $59.99 (concrete pools only); 45 ft x 1.5 in vacuum hose $96.99; Taylor K-2006 test kit $114.99.
  2. 2Leslie's product pages, chemicals, regular prices checked September 29, 2026: 3 in jumbo chlorine tablets, 50 lb bucket $224.99; liquid chlorine 4-pack of 1 gallon $29.99; muriatic acid 2-pack of 1 gallon $19.49, "not recommended" for fiberglass, vinyl liner or painted pools.
  3. 3The Training Center, CPO certification course: $390, "Tuition will increase to $390 for 2026 as required by the PHTA". Checked September 29, 2026.
  4. 4Pool & Hot Tub Alliance, Certified Pool & Spa Operator (CPO): valid 5 years; 16-hour, two-day class or a blended online option. Undated, checked September 29, 2026.
  5. 5U.S. Small Business Administration, "Register your business": no registration under your own legal name; usually less than $300. Checked September 29, 2026.
  6. 6Internal Revenue Service, "Get an employer identification number": free, issued online right away. Updated August 19, 2026.
  7. 7U.S. Census Bureau, 2022 NAICS Index File: "Swimming pool cleaning and maintenance services" under 561790. Downloaded September 29, 2026.
  8. 8Internal Revenue Service, 2025 Instructions for Schedule C (Form 1040): code 561790, "Other services to buildings & dwellings". January 2, 2026.
  9. 9Internal Revenue Service, "Self-Employment Tax" (15.3%, $400 threshold; updated June 27, 2026) and "Estimated Taxes" ($1,000 or more; updated September 25, 2026).
  10. 10Internal Revenue Service, Standard mileage rates: 76 cents a mile for business, July 1 to December 31, 2026. Page reviewed July 28, 2026.
  11. 11Texas Comptroller rule, 34 Tex. Admin. Code 3.356 (effective March 23, 1995), and Taxable Services, publication 96-259 (January 2026): pool cleaning and maintenance is taxable.
  12. 12North Carolina Department of Revenue, Services to Real Property Taxability Chart: cleaning and vacuuming an in-ground pool is taxable. Undated, checked September 29, 2026.
  13. 13Connecticut Department of Revenue Services, services subject to sales and use taxes, and Conn. Agencies Regs. 12-407(2)(i)(AA)-1 (effective April 7, 1999): providers are consumers of their supplies.
  14. 14Florida Department of Revenue rule, Fla. Admin. Code R. 12A-1.0091, and guide GT-800015 (rev. 09/15): the cleaning services rule does not name pools.
  15. 15The Florida Legislature, Fla. Stat. 489.105(3)(k) and (3)(l), 2026 Florida Statutes. Checked September 29, 2026.
  16. 16Florida Department of Health rule, Fla. Admin. Code R. 64E-9.018, Public Pool Service Technician: at least 16 hours plus a test. Amended May 24, 2009.
  17. 17Miami-Dade County, Swimming Pool Cleaner Registration: $60 a year, a CPO certificate, liability of at least $50,000 bodily injury and $25,000 property damage. Undated, checked September 29, 2026.
  18. 18Arizona Legislature, A.R.S. 32-1121 (handyman exemption under $1,000) and A.R.S. 32-1101 (contractor definition). Checked September 29, 2026.
  19. 19Arizona Registrar of Contractors rules, Ariz. Admin. Code R4-9-103 and R4-9-102: R-6, C-6 and CR-6 scope. Effective November 5, 2017.
  20. 20Contractors State License Board, D-35 Pool and Spa Maintenance classification. Undated, checked September 29, 2026.
  21. 21Contractors State License Board, Industry Bulletin #24-07 (AB 2622): minor work up to $1,000 from January 1, 2025. December 31, 2024.
  22. 22California Department of Pesticide Regulation, PUE Program Standards Compendium Vol. 1, Ch. 3, p. 3-42: pool servicing and the pest control business license. Revised October 2024.
  23. 23Nevada State Contractors Board rule, NAC 624.150 (A-10e), amended through April 19, 2024, and Nevada Legislature, NRS 624.031 (exemptions).
  24. 24Southern Nevada Health District, Registrations: Qualified Operators and Pool Companies. Undated, checked September 29, 2026.
  25. 25Texas Department of Licensing and Regulation, program list: no pool or spa program; electricians licensed. Checked September 29, 2026.
  26. 26Georgia Code via FindLaw, O.C.G.A. 43-41-2: residential contractor work over $2,500. Current as of March 28, 2024.
  27. 27Georgia Department of Public Health, Guidance for Public Swimming Pool Operators. Undated, checked September 29, 2026.
  28. 28North Carolina General Assembly, N.C.G.S. 87-1: $40,000 threshold. Last amended by S.L. 2023-108.
  29. 29Brunswick County, NC, Public Swimming Pools, quoting 15A NCAC 18A .2537(c) on operator training. Checked September 29, 2026.
  30. 30Connecticut Department of Consumer Protection, Spa and Pool Trades Licenses and Scope of Work. Undated, checked September 29, 2026.
  31. 31Insureon, "Pool and Spa Cleaning Services Insurance Costs": general liability $95 a month ($1,143 a year) for pool cleaning companies; commercial auto $250 a month ($3,001 a year) for pool and other cleaning businesses; medians of policies quoted through Insureon. Updated September 3, 2026.
  32. 32Insurance Information Institute, Business Vehicle Insurance. Checked September 29, 2026.
  33. 33Workers' compensation rules: Texas Department of Insurance (June 8, 2026); California Department of Industrial Relations (July 2025); Florida Department of Financial Services; Georgia State Board of Workers' Compensation; North Carolina Industrial Commission; A.R.S. 23-902. Checked September 29, 2026.
  34. 34Independent Pool and Spa Service Association, member benefits: route coverage during emergency or illness. Checked September 29, 2026.
  35. 35US DOT rule, 49 CFR 173.6, Materials of trade exceptions, with the 172.101 hazardous materials table. Checked September 29, 2026.
  36. 36OSHA, 29 CFR 1910.1200, Hazard Communication, and U.S. Department of Labor, elaws Employment Law Guide: OSHA (the self-employed are not covered; updated February 2024).
  37. 37Service Industry News, "California: Rising costs, decreasing profit": Southern California $175, 92% include chemicals, about 75 pools; the 75-pool example leaving $8,425 a month before taxes, with $1,900 a month of chemicals. May 31, 2026.
  38. 38Service Industry News, May 31, 2026: "What causes low service prices in Florida?" (Florida $150, nearly all include chemicals; Southeast about $300, 58%); "Where are prices higher, Texas or Arizona?" (Arizona about $150, Texas about $225; Southwest about 73% include chemicals); "What is pool service like in seasonal markets" (Northeast $433, 54%; Midwest about $255, 33%); "Pool service summer survey issue ready" ("not a purely scientific survey").
  39. 39Pool & Spa News, Nate Traylor, "So, You Want to Start a Pool Service Business": "aim for two pools an hour". April 13, 2017, updated June 11, 2025.
  40. 40Google Business Profile Help, service areas: up to 20 service areas. Checked September 29, 2026.
  41. 41U.S. Postal Service, Every Door Direct Mail: Retail at $0.26 a piece, no permit, 200 to 5,000 pieces a day per ZIP Code. Checked September 29, 2026; and 18 U.S.C. 1725 on mailboxes.
  42. 42National Pool Route Sales (a route broker), "FAQs": $5,000 to $20,000 to start a solo operation; routes at 10 to 12 times monthly billing; bank loans rare; about 50 pools the "sweet spot" for a solo operator; the builder and realtor ideas. Modified April 6, 2026. Listing AZ12234 (26 pools, $3,350 a month, $40,200) on its listings page, where seven listings checked September 29, 2026 asked 12 or 13 times monthly billing; deal terms (90-day guarantee, 10% holdback, about 30 days of training, 5-year non-compete) from its listings and FAQ.
  43. 43National Pool Route Sales, "Starting a Career": account losses of one to two percent. Modified May 15, 2019; and Pool & Spa News, "Buying routes can boost your business, but are you getting your money's worth?" (2008): about 30 percent.
  44. 44NOAA National Centers for Environmental Information, 1991-2020 U.S. Climate Normals, airport stations, compiled for 75 cities by PoolChecker (the same data as our when-to-open and when-to-close pages): 65°F dates and days at or above 100°F and 90°F. Computed September 29, 2026.
  45. 45Risks: OSHA, Heat Exposure; CDC, MMWR 68(19), May 17, 2019 (about 4,535 visits a year, 2008 to 2017); SBA Office of Advocacy, Frequently Asked Questions About Small Business 2026 (February 2026, 49.2% five-year survival, citing BLS); CPSC, Pool and Spa Drain Covers.
  46. 46Cox Automotive, used-vehicle inventory, August 2026: average listing price $27,239, all used vehicles. September 11, 2026.
  47. 47US EPA, "Safe Storage and Handling of Swimming Pool Chemicals", Chemical Safety Alert EPA 550-F-01-003: chemical goggles, liquid-impervious gloves and boots as the minimum, plus a face shield and an apron or coveralls for frequent handling. March 2001, page updated October 20, 2025.
  48. 48NOAA CAMEO Chemicals, Trichloroisocyanuric acid, reactivity profile: reacts explosively with calcium hypochlorite in water. Checked October 6, 2026.

General information for pool service businesses, not legal, tax or insurance advice. More for pool company owners: all Pro Guides.

PoolChecker Pro

Starting from zero? Start free.

Routes in drive order, visit checklists and chemical doses sized to each pool, in one app on the web, iPhone and Android. Free up to 14 pools, no card.

More for pool company owners: all Pro Guides.
